Guideline: Metrics
Relationships
Related Elements
Main Description
INTRODUCTION

Quite often, test managers are expected to answer such questions as:

  • Why does testing take so long?
  • Why has the test process not been completed yet?
  • How many defects can I still expect during production?
  • How many re-tests are still required?
  • When can testing be stopped?
  • When will the test team start the execution of the test?
  • Tell me what exactly you are up to!
  • What is the quality of the system that you have tested?
  • When can I start production?
  • How can it be that the previous test project was much faster?
  • What did you actually test?
  • How many defects have been found and what is their status?

Answering these types of questions with well-founded, factually based answers is not easy. Most questions can be answered with reference to the periodic reports as described in Report (AST). Such reports can only be created on the basis of correctly recorded relevant data, which is converted into information and then used to answer the above-mentioned questions.

Metrics on the quality of the test object and the progress of the test process are of great importance to the test process. They are used to manage the test process, to substantiate test advice and also to compare systems or test processes with each other. Metrics are important for improving the test process, in assessing the consequences of particular improvement measures by comparing data before and after the measures were adopted.

To summarise, a test manager should record a number of items in order to be able to pass well-founded judgement on the quality of the object under test as well as on the quality of the test process itself. The following sections describe a structured approach for arriving at a set of test metrics.

GQM METHOD IN SIX STEPS

There are various ways of arriving at a particular set of metrics. The most common is the Goal-Question-Metric ( GQM) method [Basili, 1994]). This is a top-down method in which one or more goals are formulated. For example: what information should I collect in order to answer those questions posed in the introduction? These goals include questions that constitute the basis for the metrics. The collected metrics should provide the answers to those questions, and the answers will indicate among other things whether the goal has been achieved or not. The summary of the GQM method described below focuses in particular on the test aspect. The GQM process is described in six steps. This is a concise description that includes only those items that are relevant to the test manager. For a more detailed description, please refer to the aforementioned GQM literature.

Step 1: Defining the goals

Measuring purely for the sake of measuring is pointless. Clear and realistic goals should be set beforehand. We distinguish two types of goals:

  • Knowledge goals (knowing where we are now). These goals are expressed in words such as evaluate, predict, or monitor. For example, “Evaluate how many hours are actually spent on re-testing” or “Monitor the test coverage”. The goal here is to gain insight.
  • Improvement goals (where do we want to go). These goals are expressed in words such as increase, decrease, improve, or achieve. Setting such goals suggests that we know there are shortcomings in the present test process or the present environment and that we want to improve these.

An example of such an improvement goal is obtaining a 20% saving on the number of testing hours at a constant test coverage within a period of 18 months. In order to ascertain this, the following two knowledge goals should be aimed at:

  • Insight into the total number of testing hours per project.
  • Insight into the achieved test coverage per project.

It is important to investigate whether the goals and the (test) maturity of the organisation match. It is pointless to aim at achieving a certain test coverage if the necessary resources (knowledge, time and tools) are not available.

Example - Knowing where we are now - Goal: Provide insight into the quality of the test object.

Step 2: Asking questions per goal

For each goal, several questions have to be asked. The questions are formulated in such a way that they act as a specification of a metric. It can also be asked, for each question, who is responsible for the test metrics supplied. From the above goal, various questions can be derived. We will limit the number of questions in this example to three.

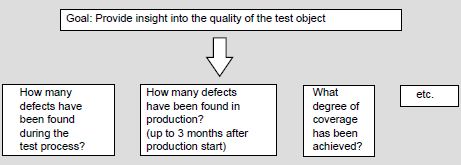

Example:

Step 3: From questions to metrics

The relevant metrics are derived from the questions, and form the full set of metrics, gathered during the test process.

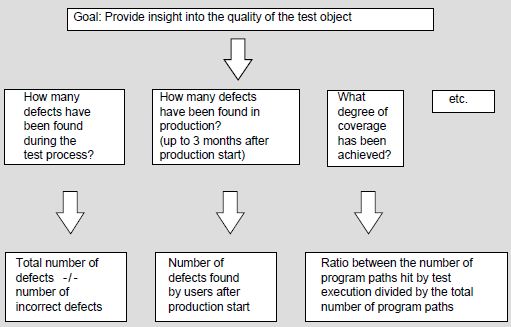

Example:

By asking the right questions, we arrive at the correct set of metrics for a certain goal. It is important to define and specify each metric correctly. For example, what exactly is a defect?

Step 4: Data collection and analysis

During the test process a variety of data is collected. One way of keeping things simple is to use forms/templates (if possible in electronic form). The data should be complete and easy to interpret. In the design of these forms, attention should be paid to the following points:

  • Which metrics are collected on the same form.
  • Validation: how easy is it to check whether the data is complete and correct.
  • Traceability: forms supplied with the date, project ID, configuration management data, data collector, etc. Take into consideration that it is sometimes necessary to preserve this data for a long time.
  • Possibility of electronic processing.

As soon as the data is collected, it should be analysed. At this point it is still possible to make corrections. Waiting too long decreases the chance of restoring the data. Bear in mind possibilities, for example, of booking time with the incorrect activity code.

Step 5: Presentation and distribution of the measurement data

The collected measurements are used both in the test reports on the quality of the product under test and in those on the test process. Proper feedback is also of importance to the motivation of those involved and the validation of the measured data.

Step 6: Relating the measurement data to the questions and goals

This last step is used to investigate to what extent the indicators (answers to the questions) offer sufficient insight into the matter of whether the goals have been achieved. This situation may be the starting point for a new GQM cycle. In this way, we are continually improving the test process.

HINTS AND TIPS

When metrics are being collected, the test manager should take the following issues into account:

  • Start with a limited set of metrics and build it up slowly.
  • Keep the metrics simple. The definition should appeal to the intuition of those involved. For example, try to avoid the use of a variety of formulas. The more complicated the formulas, the more difficult they are to interpret.
  • Choose metrics that are relatively simple to collect and easily accepted. The more difficult it is to collect data, the greater the chance that it will not be accepted.
  • Collect data electronically as much as possible. This is the quickest way of data collection and avoids the introduction of manual errors into the data set.
  • Keep an eye on the motivation of the testers to record accurately. In the case of time registration, for example, it sometimes happens that incorrect (read: not yet fully booked) codes are used.
  • Avoid complicated statistical techniques and models during presentations. Allow the type of presentation to depend on the data presented (tables, diagrams, pie charts, etc.).
  • Provide feedback to the testers as quickly as possible. Show them what you do with the information.

PRACTICAL STARTING SET OF TEST METRICS

Below is an indication of what test managers embarking on a “metrics programme” should start with. The metrics set described is a starting set that can be used in practice with little cost and effort.

  • Registration of hours, using activity codes. Register the following for each tester: date, project, TMap phase, activity and number of hours. A “Comments” field is recommended, making it possible to check whether the data has been entered correctly. Registering the hours in this way enables you to obtain insight into the time spent on each TMap phase (see figure 1). It also enables the client to check the progress of the test process. It is advisable to compile this type of timesheet on a weekly basis for projects that last up to three or four months. For projects that last longer than half a year, this can be done on a fortnightly basis. For projects that last longer than a year, it is best to report on a monthly basis.
  • Collect data about the test deliverables (test plans, test scripts, etc.), the test basis and test object. Record the following: document name, delivery  date, TMap phase upon delivery, version and a characteristic that says something about the quantity. This may be the number of test cases for the test scripts, or the number of pages for the other documents. For the test basis, the number of user requirements can be taken as a quantity characteristic.
  • Report on the progress of the defects.  An example of this type of reporting is shown in figure 2:

Figure 1: Example of hours spent on test process, per TMap phase

Figure 2: Example of a progress overview of defects

These elementary metrics (hours, documents and defects) can be used to assess the productivity of the test process. Note that this productivity should be seen in relation to the required effort and size of the test project. Example: in the first ten hours of testing we may find more defects per hour than in 400 hours of further testing, simply because the first defects are found more quickly than the last ones.

The following metrics regarding productivity can be derived from this elementary set:

  • number of defects per hour (and per hour of test execution)
  • number of test cases carried out per hour
  • number of specified test scripts per hour (and per hour of test specification)
  • number of defects per test script
  • ratio of hours spent over the TMap phases.

If the number of function points or the number of ‘kilo lines of code’ (KLOC) of the object under test is known, the following numbers can be calculated:

  • number of test hours per function point (or KLOC)
  • number of defects per function point (or KLOC)
  • number of test cases per function point (or KLOC).

For the test basis we can establish the following metrics:

  • number of test hours per page of the test basis
  • number of defects per page of the test basis
  • number of test cases per page of the test basis
  • number of pages of the test basis per function point.

When it is known how many defects occur in production during the first three months, the following metric can be determined:
  • Defect-detection effectiveness of a test level: number of found defects in a test level divided by the total number of defects present. This metric is also called the Defect Detection Percentage ( DDP). In calculating the DDP, the following assumptions are applied:
    • all the defects are included in the calculation
    • the weighed severity of the defects is not included in the calculation
    • after the first three months of the system being in production, barely any defects are present in the system.

The DDP can be calculated both per test level and overall. The DDP per test level is calculated by dividing the number of found defects from the relevant test level by the sum of this number of found defects and the number of found defects from the subsequent test level(s) and/or the first three months of production. The overall DDP is calculated by dividing the total number of found defects (from all the test levels together) by the sum of this number of found defects and the found defects from the first three months of production.

Example - DDP calculations

Test level

Found defects

System test (ST)

100

Acceptance test (AT)

60

3 Months of production

40

DDP ST (after the AT is carried out) : (100 / 100+60 ) = 63%
DDP ST (after 3 months of production) : (100 / 100+60+40 ) = 50%
DDP AT (after 3 months of production) : (60 / 60+40 ) = 60%
DDP overall : (100+60 / 100+60+40 ) = 80%

Some causes of a high or low DDP may be:

  • High DDP
    • the tests have been carried out very accurately
    • the system has not yet been used much
    • the subsequent test level was not carried out accurately.
  • Low DDP
    • the tests have not been carried out accurately
    • the test basis was not right, consequently nor were the tests derived from it
    • the quality of the test object was wrong (containing too many defects to be found during the time available)
    • the testing time has been shortened.

By recording the above-mentioned metrics, supplemented here and there with particular items, we arrive at the following list of metrics.

METRICS LIST

In the following (non-exhaustive) list of metrics, a number of commonly used metrics are mentioned, which can be used as indicators for pronouncing on the quality of the object under test or for measuring the quality of the test process and comparing against the organisation’s standard. All the indicators can of course also be used in the report to the client:

  • Number of defects found - The ratio between the number of defects found and the size of the system per unit of testing time.
  • Executed instructions - Ratio between the number of tested program instructions and the total number of program instructions. Tools that can produce such metrics are available.
  • Number of tests - Ratio between the number of tests and the size of the system (for example expressed in function points). This indicates how many tests are necessary in order to test a part.
  • Number of tested paths - Ratio between the tested and the total number of logical paths present.
  • Number of defects during production - This gives an indication of the number of defects not found during the test process.
  • Defect detection effectiveness - The total number of defects found during testing, divided by the total number of defects – estimated partly on the basis of production data.
  • Test costs - Ratio between the test costs and the total development costs. A prior definition of the various costs is essential.
  • Cost per detected defect - Total test cost divided by the number of defects found.
  • Budget utilisation - Ratio between the budget and the actual cost of testing.
  • Test efficiency - The number of required tests versus the number of defects found.
  • Degree of automation of testing - Ratio between the number of tests carried out manually and the number of tests carried out automatically.
  • Number of defects found (relative) - The ratio between the number of defects found and the size of the system (in function points or KLOC) per unit of testing time.
  • Defects as a result of modifications that are not tested - Defects because of modifications that are not tested, as a part of the total number of defects arising as a result of changes.
  • Defects after tested modifications - Defects because of modifications that are tested, as a part of the total number of defects arising as a result of changes.
  • Savings of the test - Indicates how much has been saved by carrying out the test. In other words, what would the losses have amounted to if the test had not been carried out?
